About JDR

menu opisówka

Pioneering Floating Wind Cable Technology

In 2019, JDR became the first company to deliver 66kV Dynamic Cable technology, now operational at the groundbreaking WindFloat Atlantic project. Located 20 km off the coast of Viana do Castelo, Portugal, this pioneering floating wind farm features three towering 8.4 MW turbines, standing 185m above the ocean and anchored to the seabed 100m below.

Floating wind is a next-generation renewable energy technology now entering commercialisation, following key demonstration projects such as Hywind Scotland and WindFloat Atlantic. With 40% of the global population living within 60 km of the coast, and many continental shelves extending up to 200 km offshore at depths of 60–100m, floating wind presents a significant opportunity to decarbonise densely populated coastal cities.

The UK is taking a leading role in this transition. Earlier this year, Crown Estate Scotland announced the consent of approximately 15 GW of floating offshore wind projects, opening vast opportunities for JDR and similar companies to expand in this emerging sector.

Investing in the Future of Offshore Wind

JDR is committed to driving green energy growth and supporting the race to net zero. As a registered participant in the Science-Based Targets Initiative, we are not only enabling the low-carbon energy transition but also working to minimise our own environmental impact. We are dedicated to reducing emissions, optimising resource usage, and minimising our footprint on both the environment and society.

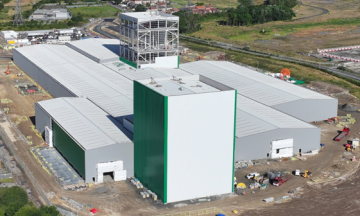

Our new state-of-the-art manufacturing facility in Cambois, Northumberland, exemplifies this commitment. Designed with sustainability in mind, the site will significantly reduce road transportation of raw materials, with plans to increase deliveries via rail and sea freight directly to the Port of Blyth from Rotterdam. The facility will be powered by renewable energy sources, leveraging local solar and wind power plants. Additionally, we are exploring rainwater capture systems, regenerative energy storage from rotating machinery, and other eco-friendly initiatives to cut emissions once the plant is operational.


JDR - new investment 2

Advancing Cable Technology at Cambois

JDR is investing in cutting-edge cable technologies to meet the growing demand for high-voltage solutions. Our new Cambois facility will play a crucial role in this effort, featuring the UK’s only quayside-located High-Voltage Continuous Catenary Vulcanisation (CCV) line. This advanced technology will extrude high-performance polymeric insulation onto large copper or aluminium conductor strand cores, allowing us to manufacture fully tested cables from raw materials to final products.

This integrated approach will enable the production of longer-length cables to support next-generation offshore wind turbines. The development will also regenerate a derelict brownfield site, marking the first offshore cable manufacturing facility of its kind in the Tyneside region.

Supporting the UK’s Offshore Wind Ambitions

JDR and TFKable’s expansion at Cambois will more than triple our current production capacity—essential to supporting the rapidly growing offshore renewable energy sector. The UK government has set ambitious targets to increase offshore wind capacity from 11.3 GW in 2021 to 50 GW by 2030. Our expanded cable manufacturing capabilities will be a key enabler in achieving this goal, ensuring efficient transmission of offshore wind power back to shore.

With our combined production capabilities in the UK and Poland, JDR is committed to securing the future of offshore wind and strengthening global efforts to transition to a low-carbon energy system.


Construction progress

February

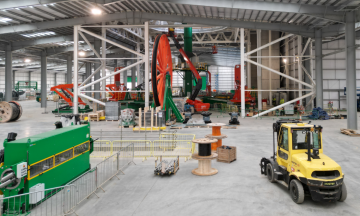

Next Stage Milestone JDR reached a significant milestone with the commencement of the installation and commissioning of advanced machinery. This crucial stage will enable the facility to efficiently produce high-quality, high-voltage subsea cables, supporting the growing demand for offshore wind and renewable energy infrastructure.

2025
August

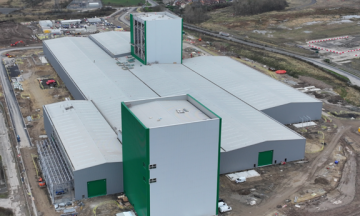

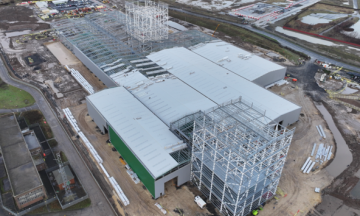

Significant progress has been made in the second phase of construction. Earlier in the year, the main building envelope was completed with insulated walls, roofing, and drainage systems for enhanced energy efficiency. The steel frames for the 45-meter CCV and VLM towers are now complete, with roofing and cladding nearing finalization on the CCV tower. Moving forward, the next phase will concentrate on machine installation and commissioning to bring the facility closer to full operational capability and support energy sector clients.

2024
May

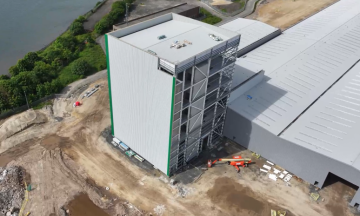

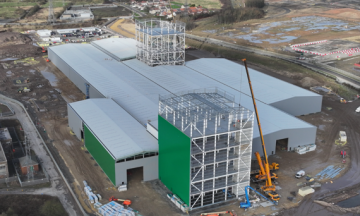

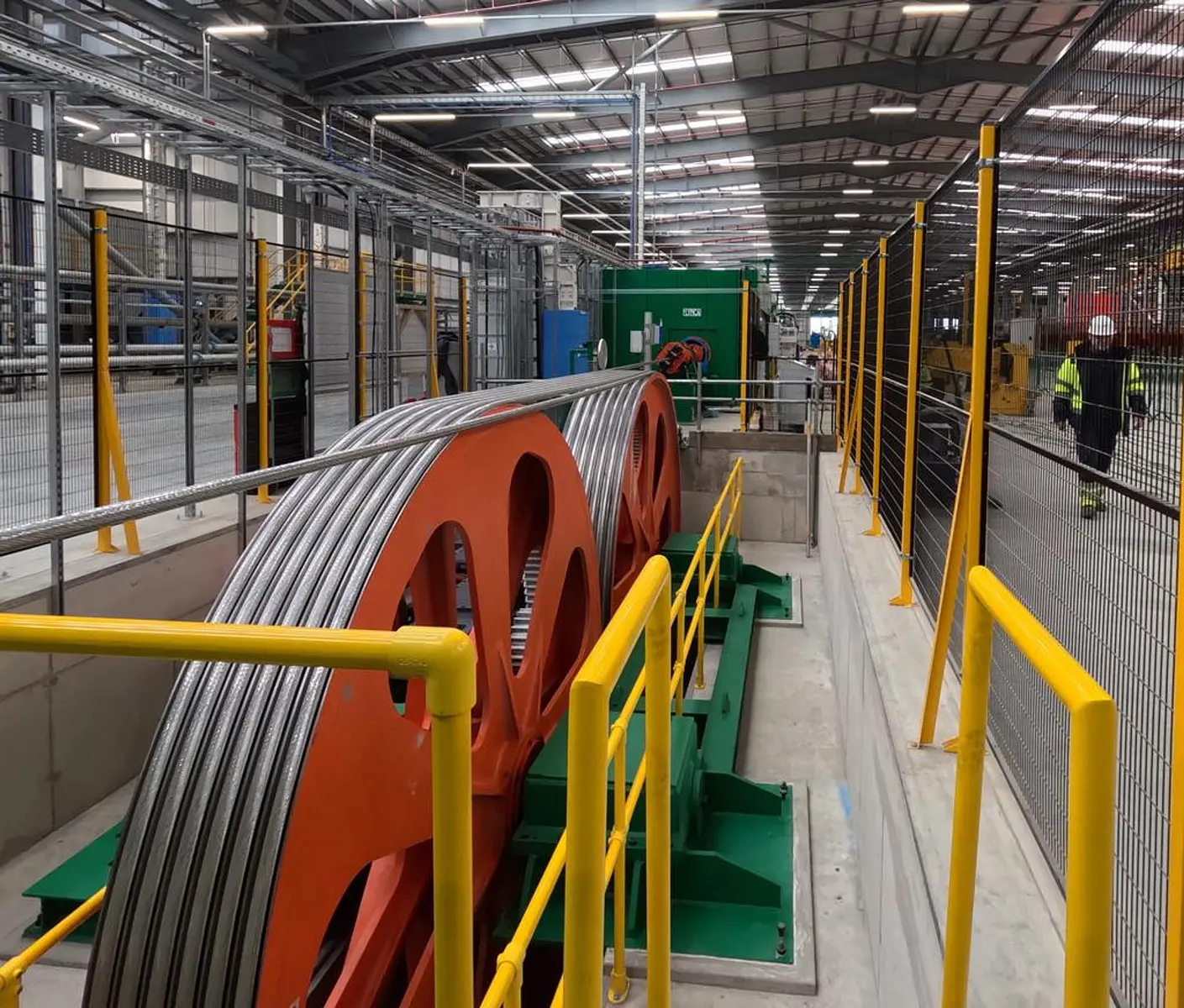

The successful delivery, lifting, and installation of the VLM capstan wheel marks a significant installation milestone. Construction on the CCV tower, including roofing and cladding, is proceeding steadily as planned.

2024
January

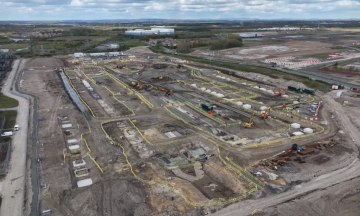

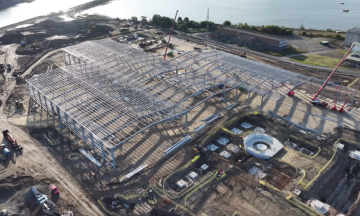

The completion of the initial construction phase, including piling and foundation work, marks a significant milestone for JDR’s subsea cable manufacturing facility. This achievement supports the increasing demand for subsea cables in the offshore renewable energy market and sets the stage for constructing the stand-alone factory buildings. This development is part of JDR's strategic plan to create the UK’s only end-to-end high-voltage subsea cable manufacturing facility, underscoring the company’s commitment to expanding product capabilities and strengthening its position in the offshore wind sector.

2024
August

The piling and foundation phase has shown significant progress, with preparatory work completed for the Vertical Lay-up Machine (VLM) foundations and incoming construction components. Machinery deliveries remain on schedule, and the steel frame is progressing east to west, shaping the facility. Preparations are also underway for the Armouring, Internal Processing, Wire Drawing, and Stranding areas as the VLM and CCV towers move toward their steel structure installations

2023
November

Construction to begin Autumn 2022, with facility operations commencing in 2025. Total private investment of £130m assisted by the UK government's Offshore Wind Manufacturing Investment Support (OWMIS) scheme.

2022
September

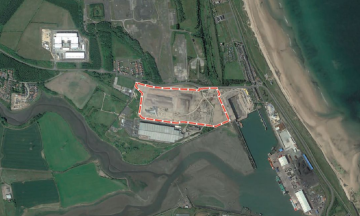

Subsea Cable Facility to Boost UK Offshore Renewables Sector JDR confirmed plans to build a £130m subsea cable manufacturing facility in Cambois, Northumberland, with construction scheduled to begin in 2022 and completion expected by 2024. The project will create 171 new jobs and safeguard 270 existing positions. The facility will focus on high voltage export and long-length array cables, including a new catenary continuous vulcanisation (CCV) line, making it the only UK site capable of full start-to-finish manufacturing for the offshore wind sector.

2021
November

A critical operational milestone has been achieved with the completion of JDR’s 2.8 km, 11kV dual circuit connection to NPg’s supply point, now fully operational. This project included a new NPg-adaptable connection, a robust cable route with high-quality cables from JDR’s Bydgoszcz plant, a comprehensive substation setup, and final commissioning. This advancement further strengthens JDR’s operational capabilities in high-voltage subsea cable manufacturing.

2024
June

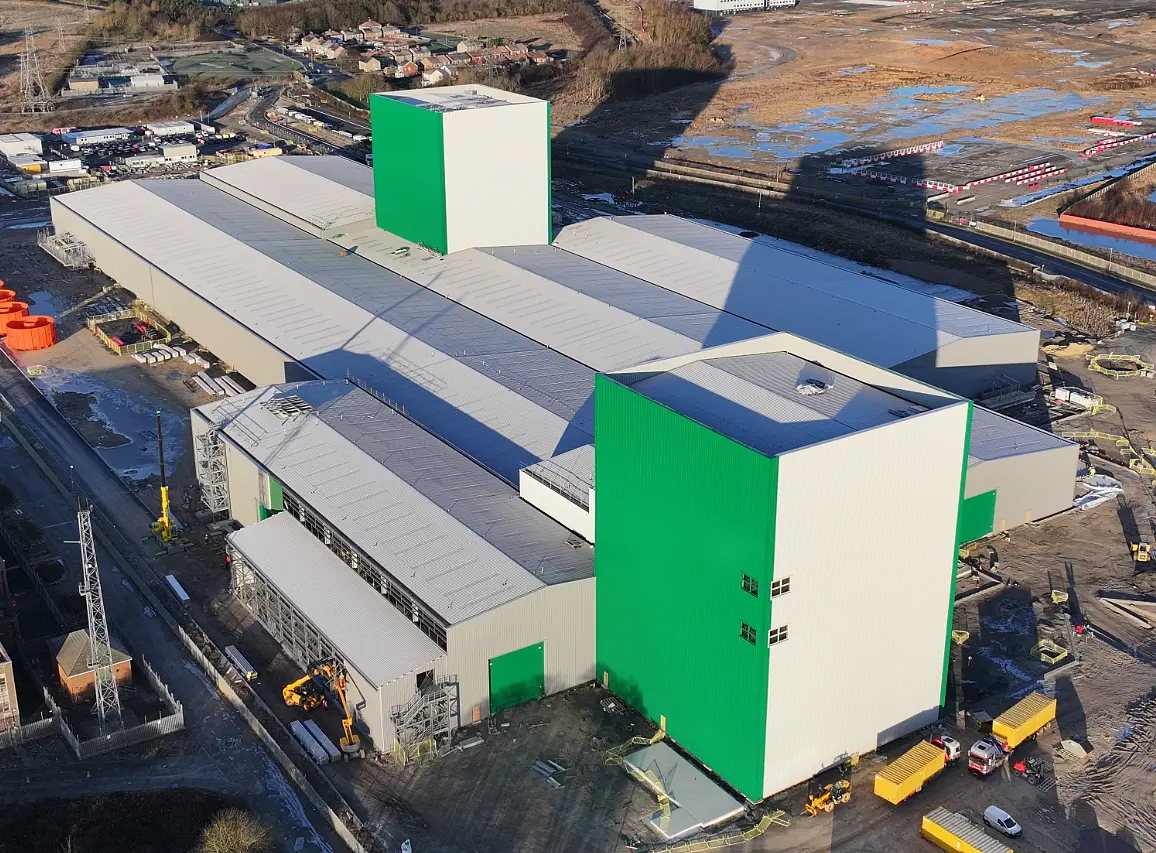

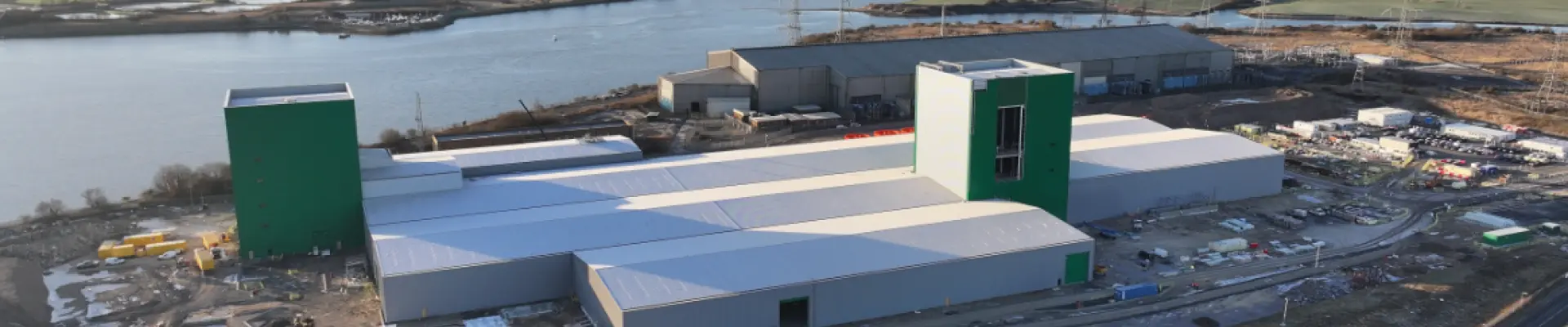

JDR Reaches Second Milestone Achieved JDR reached another key milestone with the completion of the main building envelope, making the new facility watertight. This included the installation of insulated walls, roofing, and drainage systems to improve energy efficiency and sustainability. Additionally, the steel frame construction for the 45m high Continuous Catenary Vulcanisation (CCV) and Vertical Lay-up Machine (VLM) towers was finished, with roofing and cladding for the CCV tower nearly completed.

2024
March

Construction is progressing smoothly, with the fifth floor of the VLM now cast, ongoing ground stabilization, and cladding work advancing. Structural installations for stairs and lift cores continue, with pit excavations completed in key areas, reflecting steady advancement toward major construction milestones.

2024
November

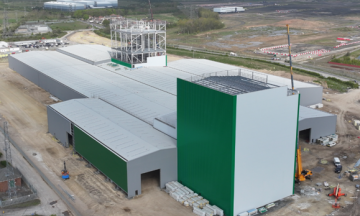

JDR Reaches Key Milestones for £130 Million Subsea Cable Facility JDR reached key milestones in constructing its £130 million subsea cable facility in Cambois, Northumberland. Over 150 foundations were placed, and the steel frame for the main hall was erected. The facility will be the only UK site capable of full start-to-finish manufacturing of high-voltage subsea cables, supporting the growing offshore wind sector. The project also emphasizes sustainability by reusing foundations from the former coal power station and supporting local supply chains.

2023
November

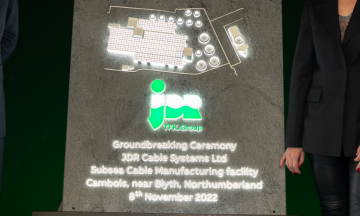

JDR Starts Construction – Groundbreaking Event on £130m Subsea Cable Facility JDR officially broke ground on its 69,000 sqm subsea cable manufacturing facility in Cambois, near Blyth. This project will support the offshore wind market and create 171 local jobs during the construction phase. The facility will feature the only catenary continuous vulcanisation (CCV) line in the UK for high voltage subsea cable production. Supported by the UK government’s BEIS Offshore Wind Manufacturing Investment Support Scheme, the facility is set to make a significant impact on both the local economy and the offshore energy sector.

2022
June

Final Grant Agreement for £130m Blyth Subsea Cable Facility JDR secured a final agreement for financial support under the UK’s Offshore Wind Manufacturing Scheme (OWMIS) for its subsea cable manufacturing facility in Cambois. Construction began in summer 2022, with operations set for 2024. The £130m investment will not only expand JDR’s product range but also create 171 new jobs and safeguard 270 existing ones, supporting the growing offshore renewables market.

2022
2025
February

Next Stage Milestone JDR reached a significant milestone with the commencement of the installation and commissioning of advanced machinery. This crucial stage will enable the facility to efficiently produce high-quality, high-voltage subsea cables, supporting the growing demand for offshore wind and renewable energy infrastructure.

2024
November

A critical operational milestone has been achieved with the completion of JDR’s 2.8 km, 11kV dual circuit connection to NPg’s supply point, now fully operational. This project included a new NPg-adaptable connection, a robust cable route with high-quality cables from JDR’s Bydgoszcz plant, a comprehensive substation setup, and final commissioning. This advancement further strengthens JDR’s operational capabilities in high-voltage subsea cable manufacturing.

2024
August

Significant progress has been made in the second phase of construction. Earlier in the year, the main building envelope was completed with insulated walls, roofing, and drainage systems for enhanced energy efficiency. The steel frames for the 45-meter CCV and VLM towers are now complete, with roofing and cladding nearing finalization on the CCV tower. Moving forward, the next phase will concentrate on machine installation and commissioning to bring the facility closer to full operational capability and support energy sector clients.

2024
June

JDR Reaches Second Milestone Achieved JDR reached another key milestone with the completion of the main building envelope, making the new facility watertight. This included the installation of insulated walls, roofing, and drainage systems to improve energy efficiency and sustainability. Additionally, the steel frame construction for the 45m high Continuous Catenary Vulcanisation (CCV) and Vertical Lay-up Machine (VLM) towers was finished, with roofing and cladding for the CCV tower nearly completed.

2024
May

The successful delivery, lifting, and installation of the VLM capstan wheel marks a significant installation milestone. Construction on the CCV tower, including roofing and cladding, is proceeding steadily as planned.

2024
March

Construction is progressing smoothly, with the fifth floor of the VLM now cast, ongoing ground stabilization, and cladding work advancing. Structural installations for stairs and lift cores continue, with pit excavations completed in key areas, reflecting steady advancement toward major construction milestones.

2024
January

The completion of the initial construction phase, including piling and foundation work, marks a significant milestone for JDR’s subsea cable manufacturing facility. This achievement supports the increasing demand for subsea cables in the offshore renewable energy market and sets the stage for constructing the stand-alone factory buildings. This development is part of JDR's strategic plan to create the UK’s only end-to-end high-voltage subsea cable manufacturing facility, underscoring the company’s commitment to expanding product capabilities and strengthening its position in the offshore wind sector.

2023
November

JDR Reaches Key Milestones for £130 Million Subsea Cable Facility JDR reached key milestones in constructing its £130 million subsea cable facility in Cambois, Northumberland. Over 150 foundations were placed, and the steel frame for the main hall was erected. The facility will be the only UK site capable of full start-to-finish manufacturing of high-voltage subsea cables, supporting the growing offshore wind sector. The project also emphasizes sustainability by reusing foundations from the former coal power station and supporting local supply chains.

2023
August

The piling and foundation phase has shown significant progress, with preparatory work completed for the Vertical Lay-up Machine (VLM) foundations and incoming construction components. Machinery deliveries remain on schedule, and the steel frame is progressing east to west, shaping the facility. Preparations are also underway for the Armouring, Internal Processing, Wire Drawing, and Stranding areas as the VLM and CCV towers move toward their steel structure installations

2022
November

JDR Starts Construction – Groundbreaking Event on £130m Subsea Cable Facility JDR officially broke ground on its 69,000 sqm subsea cable manufacturing facility in Cambois, near Blyth. This project will support the offshore wind market and create 171 local jobs during the construction phase. The facility will feature the only catenary continuous vulcanisation (CCV) line in the UK for high voltage subsea cable production. Supported by the UK government’s BEIS Offshore Wind Manufacturing Investment Support Scheme, the facility is set to make a significant impact on both the local economy and the offshore energy sector.

2022
November

Construction to begin Autumn 2022, with facility operations commencing in 2025. Total private investment of £130m assisted by the UK government's Offshore Wind Manufacturing Investment Support (OWMIS) scheme.

2022
June

Final Grant Agreement for £130m Blyth Subsea Cable Facility JDR secured a final agreement for financial support under the UK’s Offshore Wind Manufacturing Scheme (OWMIS) for its subsea cable manufacturing facility in Cambois. Construction began in summer 2022, with operations set for 2024. The £130m investment will not only expand JDR’s product range but also create 171 new jobs and safeguard 270 existing ones, supporting the growing offshore renewables market.

2021
September

Subsea Cable Facility to Boost UK Offshore Renewables Sector JDR confirmed plans to build a £130m subsea cable manufacturing facility in Cambois, Northumberland, with construction scheduled to begin in 2022 and completion expected by 2024. The project will create 171 new jobs and safeguard 270 existing positions. The facility will focus on high voltage export and long-length array cables, including a new catenary continuous vulcanisation (CCV) line, making it the only UK site capable of full start-to-finish manufacturing for the offshore wind sector.
